How to digitalize a distribution operation without replacing the ERP
Visibility, tracking and customer-facing status do not require a new ERP. They require a read-only integration layer, an event log and one status page, built on records the ERP already holds.
Contents
A distribution business does not need a new ERP to gain visibility. The ERP already records orders, stock movements and deliveries with timestamps. What's missing is a read-only integration layer, an event log and one status page customers can check. Build those first and decide about replacement later, with evidence.
Key takeaways
- Panorama Consulting's 2026 ERP Report, from 170 organizations surveyed between January 2025 and January 2026, found more than a quarter of projects went over budget and almost a quarter over schedule.
- In that survey the most common cause of budget overrun was an unexpected need for additional technology, and of schedule overrun, organizational issues.
- McKinsey and Oxford, reviewing more than 5,400 IT projects in 2012, found large ones ran 45% over budget and 7% over schedule while delivering 56% less value than predicted.
- Gartner listed data quality and integration complexity among the obstacles slowing cloud ERP adoption in February 2026. Neither is removed by a migration.
What a replacement project actually costs
Panorama's 2026 report puts the median project at nine months. That is nine months during which the warehouse still calls the office to ask where a pallet is.

The overrun evidence is broader than ERP alone, and worth reading with that caveat. McKinsey, working with the University of Oxford, reviewed more than 5,400 IT projects in 2012 and found that large ones, above $15 million USD, ran 45% over budget and 7% over schedule while delivering 56% less value than predicted. Flyvbjerg and Budzier reported in Harvard Business Review in September 2011 that across 1,471 IT projects the average cost overrun was 27%, and that one in six was a “black swan” with a cost overrun averaging 200% and a schedule overrun close to 70%.
Across 1,471 IT projects, the average cost overrun was 27%, and one in six projects overran cost by 200% on average and schedule by almost 70%. Source: Flyvbjerg and Budzier, Harvard Business Review, September 2011.
None of this makes ERP replacement wrong. It makes it an option to compare against a cheaper one that has been costed, not the only path.
The data you already have
Open a distribution ERP and the records are there: order header and lines, reservation, picking, dispatch, delivery note, invoice, returns. Most write a timestamp and a user on each state change. The gap is rarely capture; it is that nothing outside the ERP can read it.
Panorama's March 2026 announcement reported business intelligence as the most widely deployed digital initiative in its survey, at 55.3% of organizations. Reporting is usually the first thing companies get out of a closed system, and it proves the extraction path exists.
This is the point where digitalization stops being a software purchase and becomes an operations problem with a technical component.
The integration surface, ordered by risk
Work outward from the safest access pattern.
- Read-only extract. A scheduled copy of the tables you need into a separate store. No write path, no risk to the system of record, and enough for dashboards and a status page.
- Near-real-time reads. A documented API or a change-data-capture feed, when hourly is not good enough.
- Writes. Last, narrow, and only for fields the ERP treats as peripheral: delivery status, proof of delivery, a photo. Route them through a queue with idempotency keys.
Writing back into a system of record deserves the same caution as giving an automated agent write access to a CRM. One malformed retry against a stock table costs more than the feature was worth.
What to build first
Three things, in this order.

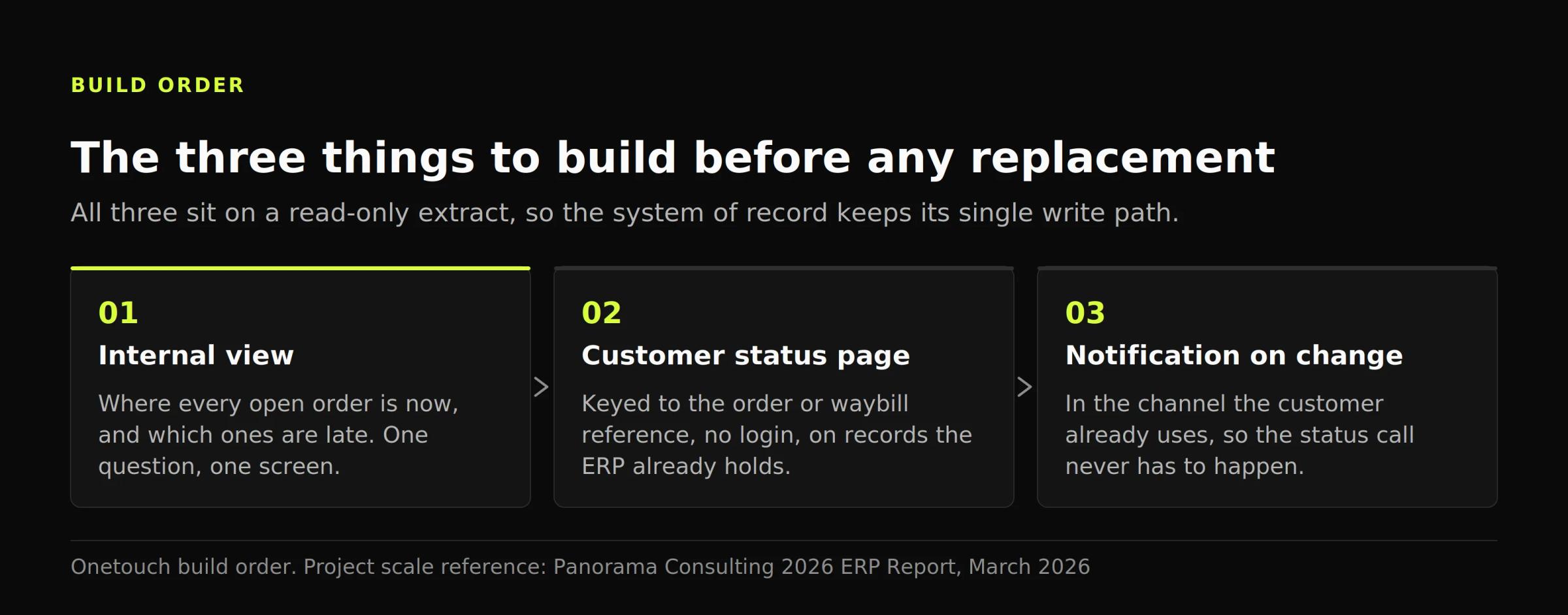

First, an internal view answering one question: where is every open order now, and which are late. Second, a customer-facing status page keyed to the order or waybill reference, no login. Third, a notification on state change, in the channel the customer already uses.
An order status request nobody answers is the same commercial failure as a qualified lead dying between marketing and sales: a customer asking a question your systems can answer and your process doesn't.
Panorama Consulting's 2026 ERP Report, based on 170 organizations surveyed between January 2025 and January 2026, found more than a quarter of ERP projects exceeded budget and almost a quarter exceeded schedule. Source: Panorama Consulting, March 2026.
What this does not fix
Exposing data makes bad data visible faster; it does not clean it. Gartner's February 2026 release named data quality, integration complexity and skills gaps among the obstacles slowing cloud ERP adoption. All three survive a migration intact.
Duplicate customer records, three spellings of one address and a product master nobody owns will surface on the status page within a week. That is useful, and it is also the work. Before layering automation on top, apply the questions you would apply to any AI budget request.
FAQ
Doesn't this create a second system to maintain?
It creates a thin one. A read-only store and a status page are far smaller than an ERP, and both can be retired the day a replacement delivers the same function. Treat the integration layer as a documented, versioned contract rather than scripts on one machine.
When is replacement actually the right call?
When the ERP no longer supports a business rule you need, when the vendor has ended support, or when the license and hosting cost exceeds a credible migration. Poor visibility on its own is not that trigger, because visibility is the cheaper problem to solve separately.
How long should the first version take?
Weeks, not quarters. Panorama's 2026 median ERP project was nine months, so a visibility project that approaches that scale has quietly become a replacement. If the first useful screen is more than one quarter away, the scope is wrong.
Can AI do this instead?
Not instead. Gartner forecasts that AI-enabled solutions will take 62% of cloud ERP spending by 2027, against 14% in 2024, but a model still needs a clean, readable event stream. The integration layer is what makes that stream exist.
Where to start
Start with the read-only extract and one screen showing where every open order is. Ship the customer status page next, then notifications, then count how many status calls stop arriving. That number is the business case, and in six months it will tell you what no vendor demo can: whether the ERP was ever the constraint.
