Cash flow is a design constraint, not an accounting detail
Profit and cash are different numbers, and only one pays salaries. How payment terms, deposits and milestone structure decide what a services company can take on, and what to change first.
Contents
Payment terms decide what a services company can build. A studio can be profitable on paper and still run out of money, because profit is recorded when work is invoiced and cash arrives weeks later. Half of US small businesses hold a cash buffer of 27 days or less, which is shorter than most project cycles.
Key takeaways

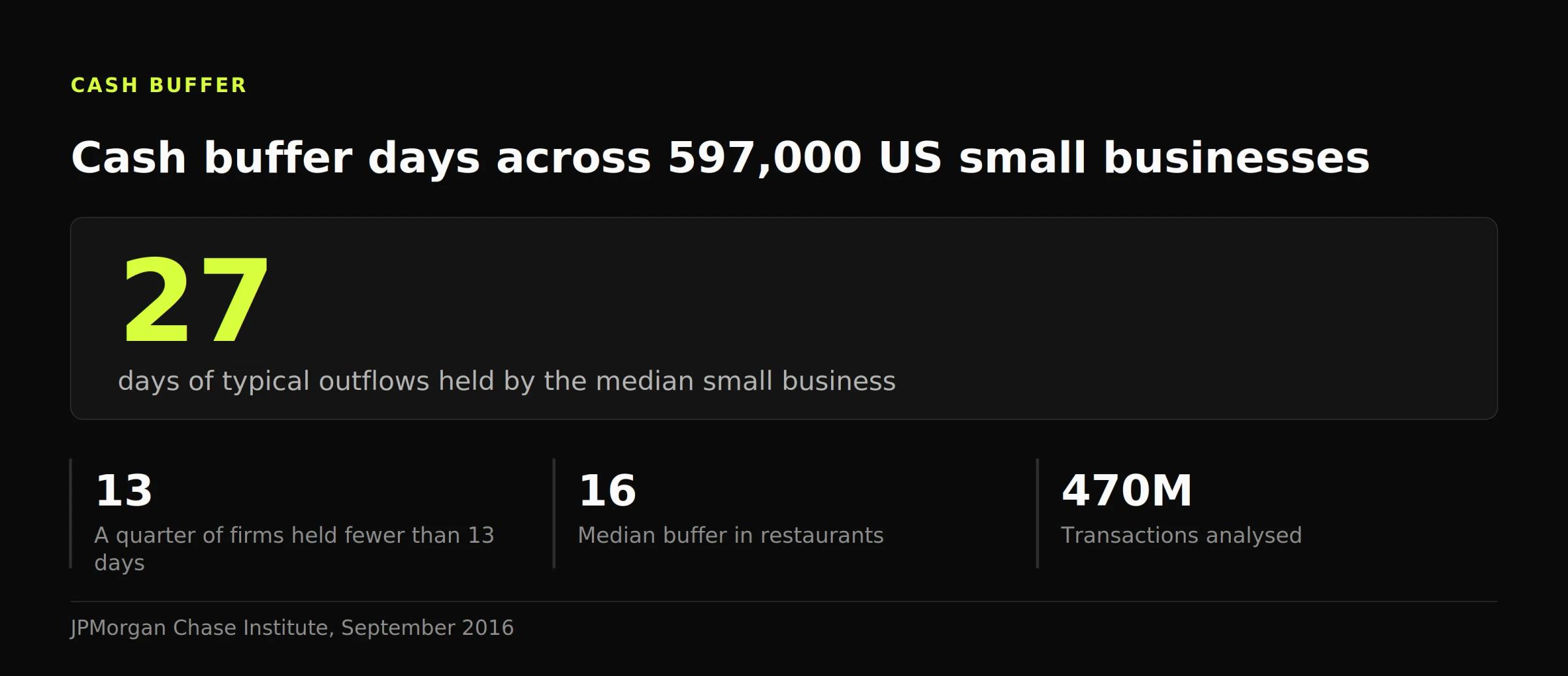

- The JPMorgan Chase Institute found a median cash buffer of 27 days across 597,000 US small businesses, and 16 days in restaurants (September 2016).
- Roughly a quarter of those businesses held fewer than 13 days of buffer, so a single late invoice is a payroll event.
- The 2017 Small Business Credit Survey reported that 64% of US employer firms faced a financial challenge in the prior year and 40% struggled to pay operating expenses.
- Intrum surveyed 9,607 European companies: 28% said late payment held back growth and 21% said it stopped them hiring (2018).
- Milestones tied to verifiable deliverables, not to calendar dates, are the cheapest cash-flow instrument a studio has.
Profit and cash are not the same number
Accrual accounting records revenue when you earn it. Your bank records it when the money lands. Between the two sit the approval cycle, the purchase order, the invoicing window and the client's payment run.
A studio that grows fast makes this gap worse. Every new project adds salaries and subcontractors now against cash that arrives in sixty or ninety days. Growth consumes cash before it produces any, which is why healthy P&Ls and empty accounts coexist so often.
The JPMorgan Chase Institute analyzed 470 million transactions from 597,000 US small businesses and found a median cash buffer of 27 days of typical outflows. A quarter of firms held fewer than 13 days; restaurants held 16 days at the median. (JPMorgan Chase Institute, September 2016)
The Federal Reserve Banks' survey of 8,169 US small employer firms points the same way. 64% reported a financial challenge in the previous twelve months, and 40% named paying operating expenses.
What payment terms do to project design
Terms are not a finance detail bolted on after the scope is agreed. They change what scope is safe to agree to.

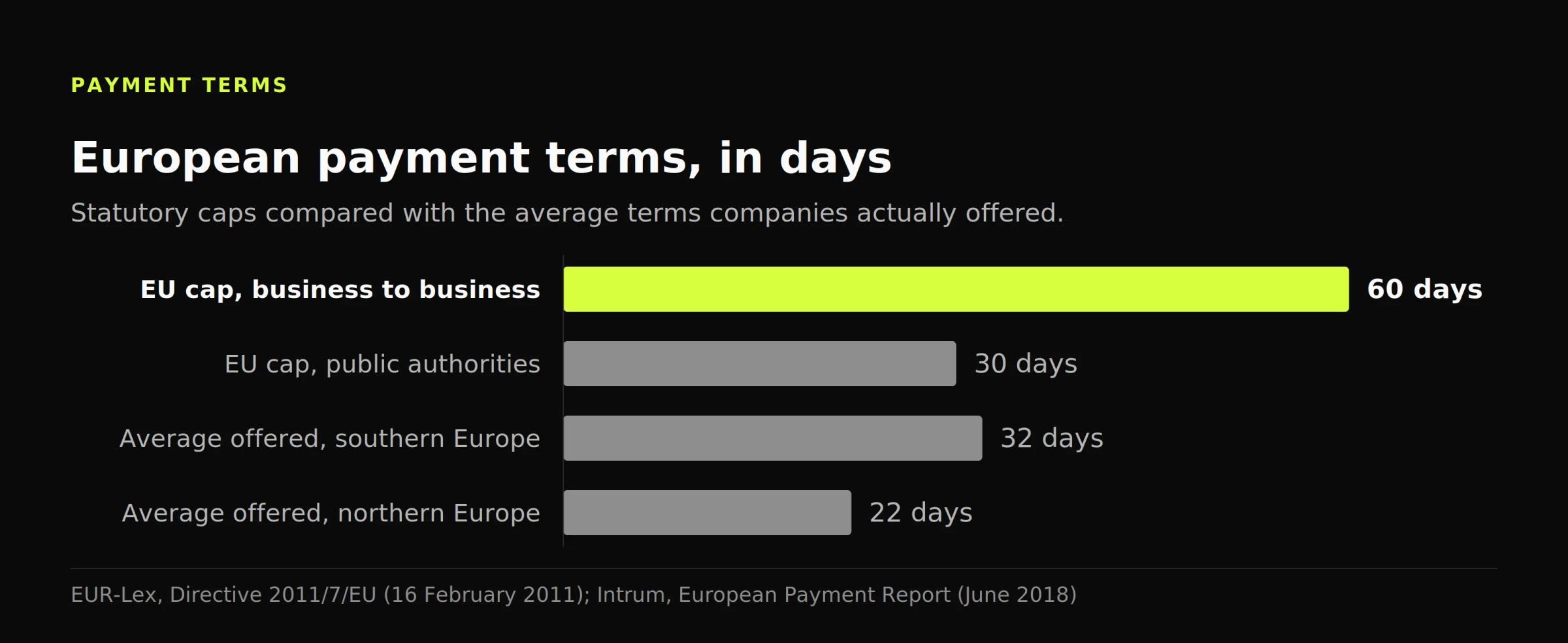

A four-month build invoiced at completion asks a small studio to fund four months of payroll. Split into four accepted stages, it asks for one. The work is identical; the risk is not, and the second version can be quoted lower because it carries less financing cost. Average B2B terms offered in Europe ran to 22 days in the north and 32 days in the south.
Intrum's European Payment Report 2018 surveyed 9,607 companies across 29 European countries. 28% said late payment restricted their growth and 21% said it prevented them from hiring. (Intrum, June 2018)
In the European Union there's a floor under this. Directive 2011/7/EU caps business-to-business payment periods at 60 calendar days unless a longer term is expressly agreed and not grossly unfair. It holds public authorities to 30 days in most cases. It also gives the creditor a minimum fixed sum of €40 in recovery costs once interest becomes due.
Milestones that follow the work, not the calendar
Date-based milestones invoice on the fifteenth whether or not anything was accepted. They produce disputes, because the client pays for elapsed time rather than for something they can inspect.
Tie each milestone to an artifact the client signs off: discovery output, design direction, staging environment live, production launch. Each one is verifiable, which makes the invoice hard to argue with.
Three defaults are worth holding. A deposit before scheduling anyone, because a booked team is a real cost. Stage payments large enough to cover that stage's payroll, not a token percentage. And a written pause clause, so an unpaid invoice stops the clock instead of financing the client. Fixed stages are also why we quote scope rather than hours.
What this changes about which work you take
Cash constraints should shape the pipeline, not just the paperwork. A large project on 90-day terms can be worth less than two small ones paid in 15 days, even at a lower margin. Solvency through the quarter is the tiebreaker, not gross profit.
Discounting to win work makes this worse twice: less margin and, usually, worse terms conceded in the same negotiation. That's the trap behind selling creative work in a price-driven market.
The same logic argues for surfacing the deadline driver and the approval chain before pricing, which is exactly what the four questions a brief should answer are for. Clients also accept staged payment more readily once they see a site as an asset with a running cost rather than a one-time purchase.
FAQ
How large should the deposit be?
Large enough to cover mobilization: the first stage's payroll plus any third-party costs you commit to on day one. A percentage rule invented for round numbers usually under-covers small projects and over-asks on large ones. Anchor it to real outflows and it becomes straightforward to justify.
Is it reasonable to stop work over one unpaid invoice?
Yes, if the contract says so and the notice period is written down. A pause clause protects both sides: it converts an ambiguous drift into a dated decision. Enforcing it once, early and politely, is far cheaper than financing a client for a quarter and discovering the problem at handover.
What is a healthy cash buffer for a small studio?
More than the median. The JPMorgan Chase Institute measured 27 days across US small businesses in September 2016, and a quarter of firms sat under 13 days. For project work with long approval cycles, a buffer that covers one full payment cycle plus payroll is a more useful target than a flat number of days.
Do late-payment rules actually help?
They set a default and a price for delay. Directive 2011/7/EU caps most business-to-business terms at 60 days and gives the creditor a €40 minimum recovery sum plus statutory interest. Its practical value is turning an unreasonable term into a negotiation with a rule behind it, rather than a favor.
Where to start
Change the terms before you change the pricing. Put a mobilization deposit and stage-based invoicing into the next three proposals, add a written pause clause, and track days sales outstanding monthly. Six months from now you'll know something you can't know today: which client segment actually pays on your terms. That number should decide which work you chase next year.
